What Is A Pre-Engineered Steel Building? Definition, Structure, Advantages and Disadvantages, Construction Process, Applications, and Construction Costs

07/01/2026
Related Post

A pre-engineered building (PEB) or pre-engineered steel building is a type of structure constructed using steel components that are designed by a PEB supplier or manufacturer, fabricated and erected based on available technical and architectural drawings.

The process of creating a complete structure consists of three stages: design, fabrication of components, and on-site erection (combined with inspection and quality management). In some industrial sectors, these buildings are also referred to as pre-engineered metal buildings (PEMB).

pre-engineered building
What Is a Pre-Engineered Steel Building?

These structures are becoming increasingly popular due to the availability of many aesthetically pleasing frame designs, cost efficiency, and customization capabilities enabled by computer-aided technology.

HOW IS A PRE-ENGINEERED STEEL BUILDING DIFFERENT FROM A STEEL FRAME BUILDING?

A pre-engineered steel building is a type of structure commonly used in industrial projects (workshops, factories, plants, etc.) and public works (parking lots, multi-storey garages, etc.), where repetitive modules are required and large clear spans are demanded.

When fabricated uniformly in factories and transported to the site for assembly, this method saves significant time and costs.

A steel frame building, on the other hand, refers to any structure that uses a steel load-bearing frame system instead of reinforced concrete.

These two concepts overlap but are not entirely identical.

A pre-engineered steel building is a steel frame building; however, a steel frame building may not necessarily be fabricated in standardized modules or designed for large clear spans like a pre-engineered building.

Pre-engineered buildings can sometimes achieve spans of up to 80 meters (or more) without any intermediate columns.

Steel frame buildings may have creative architectural forms based on custom designs by architects, whereas pre-engineered steel buildings must maintain modularity and therefore cannot accommodate excessive form variations.

STRUCTURE OF A PRE-ENGINEERED STEEL BUILDING

A pre-engineered steel building consists of three main components:

Primary load-bearing frame: Similar to reinforced concrete buildings, pre-engineered steel buildings also have foundations to ensure structural stability. In addition, they include roof load-bearing structures, crane beams, wind bracing systems, bracing members, columns, and I-shaped rafters forming the main structural frame.

Secondary members: These include partitions, partition support frames, staircases, roof purlins, working floors, Z- and C-shaped wall purlins, and related components.

Cladding and enclosure materials: A complete building cannot function without enclosure and shaping elements such as roofing sheets, fiber cement cladding panels for interior and exterior finishes, cement floor boards, cemboard panels, steel sheets, etc., which define space and protect the structure from external environmental factors. Aesthetic appearance is largely determined by these cladding and enclosure materials.

APPLICATIONS OF PRE-ENGINEERED BUILDINGS

With advantages in structural durability, design flexibility, and short construction time, pre-engineered steel buildings are increasingly chosen by enterprises and investors. This building type is widely applied in various fields as follows:

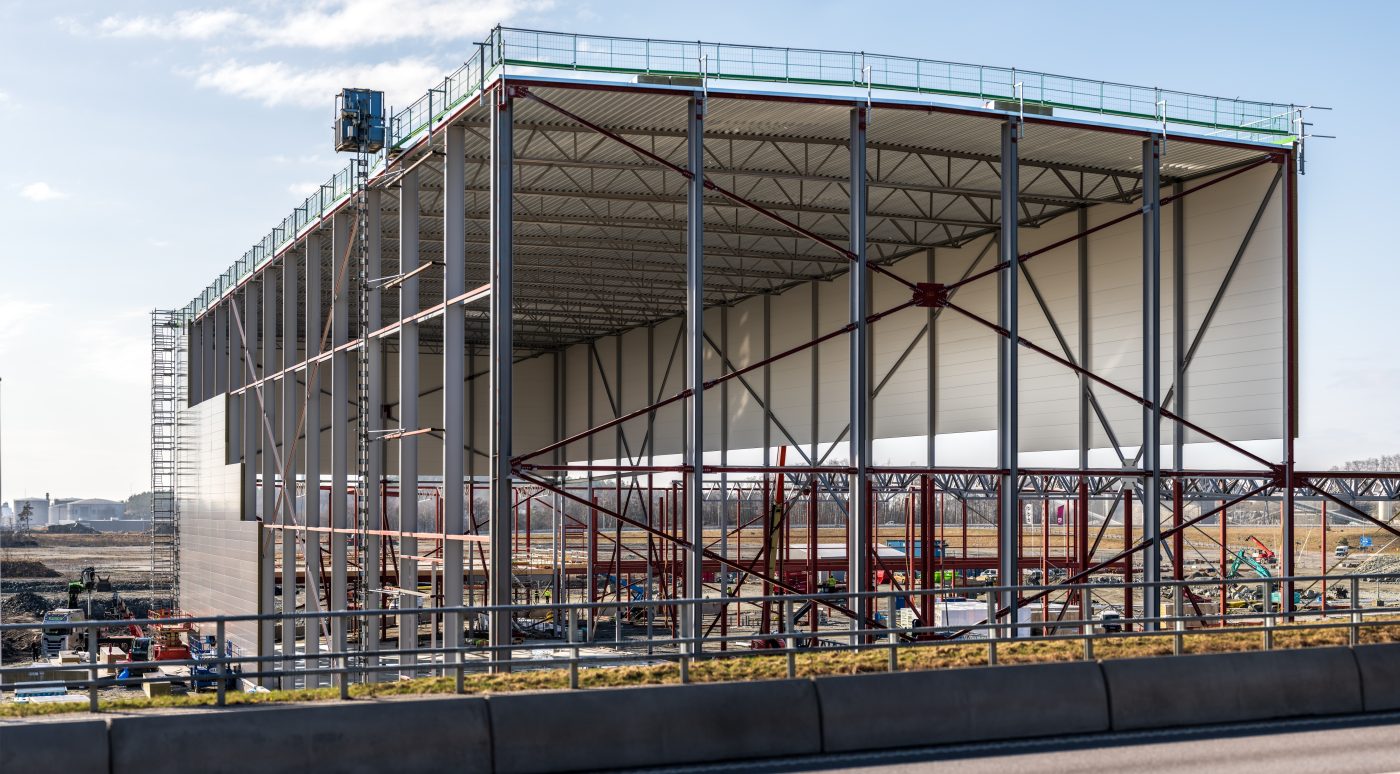

Industrial projects

In the industrial sector, pre-engineered steel buildings are especially suitable for large-scale projects requiring fast completion and high load-bearing capacity. Optimized steel frame systems create wide spaces with minimal intermediate columns, enhancing floor area utilization and facilitating production line layout.

Manufacturing plants often adopt this model to allow easy installation of machinery and equipment, as well as flexible adjustments for technological changes or capacity expansion. This solution suits industries such as mechanical engineering, textiles, wood processing, packaging, and industrial component manufacturing.

For warehouses and logistics centers, steel structures allow seamless integration of technical systems such as heavy-duty overhead cranes, high-rise racking systems, forklift circulation paths, and automated loading and unloading doors. Many projects are designed to comply with international standards for safety, fire protection, and sustainable development.

In food processing, pharmaceutical, or electronics factories, pre-engineered steel buildings facilitate environmental control, scientific technical system layout, and compliance with strict hygiene, safety, and quality standards, while still ensuring schedule adherence and investment efficiency.

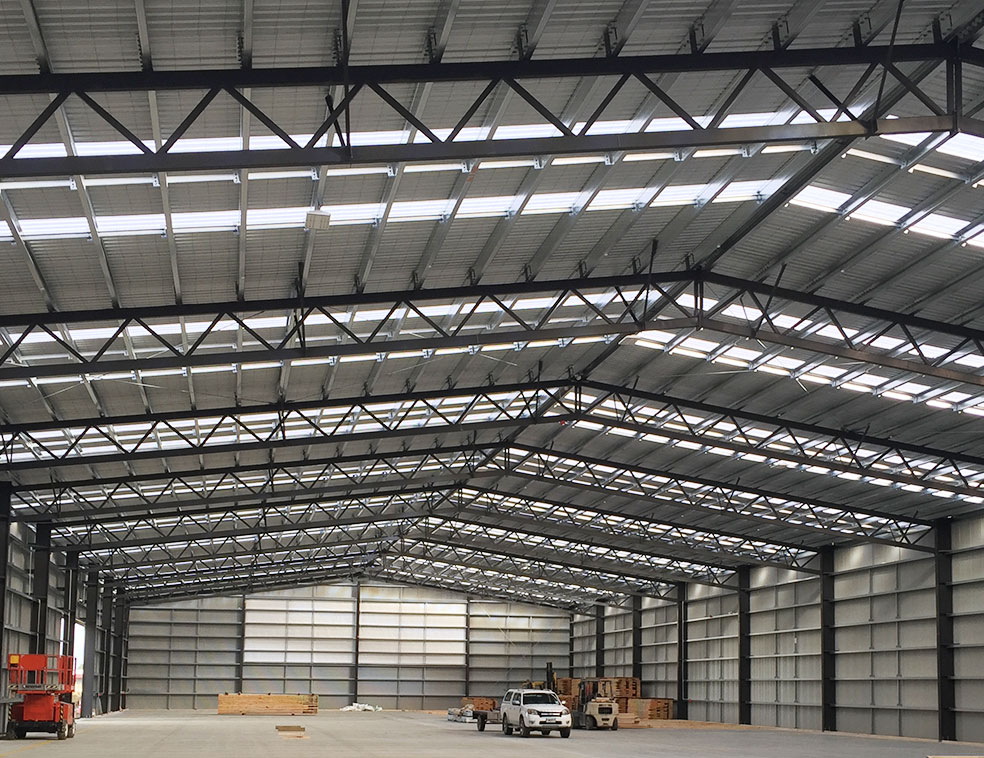

Industrial projects
Pre-engineered steel buildings are especially suitable for large-scale projects requiring fast completion and high load-bearing capacity.
Industrial projects
steel structures allow seamless integration of technical systems such as heavy-duty overhead cranes

Commercial projects

In the commercial sector, pre-engineered steel buildings are increasingly favored due to their ability to create open spaces, flexible designs, and modern architectural styles. This solution suits businesses seeking spacious premises that are easy to arrange and quick to put into operation.

Showrooms, restaurants, cafés, and service centers often use steel structures to create airy spaces and facilitate interior layout. When combined with modern materials such as glass, aluminum, or decorative panels, these buildings ensure durability while enhancing aesthetics and brand identity.

For supermarkets, shopping centers, and office buildings, pre-engineered steel buildings allow flexible space planning, easy installation of technical systems such as lighting, air conditioning, elevators, and convenient expansion or renovation during operation.

Commercial projects
Supermarkets, shopping centers, and office buildings, pre-engineered steel buildings allow flexible space planning

Agricultural projects

In modern agriculture, pre-engineered steel buildings play an important role thanks to fast construction, reasonable cost, and easy adaptation to different production models. Durable steel structures withstand weather impacts and suit long-term production conditions.

For livestock farms, pre-engineered steel buildings provide spacious, well-ventilated environments that facilitate cleaning and environmental control, thereby improving farming efficiency. In crop production, steel frames are used for greenhouses and net houses combined with automated irrigation systems, optimizing plant growth conditions and reducing operating costs.

Additionally, agricultural storage facilities using steel structures help maintain stable temperature and humidity, extending storage time and preserving post-harvest product quality.

Agricultural projects

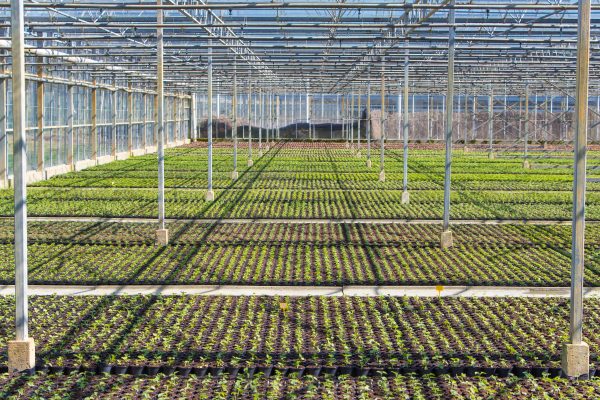

Large Dutch greenhouse flower nursery with seedlings

Residential projects

Not limited to production and commerce, pre-engineered steel buildings are increasingly applied in residential construction due to fast construction time and high flexibility. This model suits projects requiring urgent deployment such as temporary housing, resettlement areas, modular housing, or projects in remote regions.

Worker dormitories using pre-engineered steel buildings shorten construction time, reduce initial investment costs, and allow easy expansion when demand increases. In addition, auxiliary facilities such as guard houses, operation offices, and site toilets are often assembled from steel structures for easy dismantling, relocation, and reuse across multiple projects.

Residential projects
Pre-engineered steel buildings are increasingly applied in residential construction due to fast construction time and high flexibility

ADVANTAGES AND DISADVANTAGES OF PRE-ENGINEERED STEEL BUILDINGS

Pre-engineered steel buildings have their own advantages and disadvantages as outlined below:

Advantages

Steel frame buildings apply advanced scientific and engineering technologies, offering many advantages such as:

  • Ability to meet all load-bearing and durability requirements
  • Lower cost compared to reinforced concrete solutions
  • Fast installation and construction; erection time is estimated at only one-third of reinforced concrete construction time, as components are factory-fabricated and assembled on site like Lego blocks
  • High design flexibility, allowing investors to create modern, impressive, and unique steel buildings; large clear spans maximize usable space
  • Reduced structural weight, lowering foundation loads and suitable for weak soil or seismic-prone areas
  • Easy dismantling, relocation, reuse, or liquidation

Disadvantages

Poor fire resistance

Although steel is non-combustible, at temperatures of 500–600°C it softens and deforms, losing load-bearing capacity and causing potential structural collapse. Its fire resistance may even be lower than laminated timber. This limits its application in residential buildings.

Solution: Apply fire-resistant coatings or encase steel structures with fireproof materials.

Susceptibility to corrosion in hot and humid environments

In climates like Vietnam’s, especially in aggressive environments, steel corrosion may damage structures.

Solution: Apply suitable protective coatings or galvanize steel with zinc or aluminum.

Relatively lower durability

Although addressing many limitations of reinforced concrete such as cost, construction time, manpower, and structural load, pre-engineered steel buildings may be less robust.

Solution: Use high-quality materials with proper warranties and regular maintenance to extend service life.

COST – EFFECTIVE AND TIME – SAVING PRE – ENGINEERED BUILDING CONSTRUCTION PROCESS

Preparation stage

Steel frame

The steel frame is one of the main and indispensable materials in a pre-engineered building. Depending on each project, the investor selects different sizes and specifications.

At this stage, clear spans, overall building dimensions, width, and height are selected from the manufacturer’s or contractor’s catalog.

All steel structures can be prefabricated in a synchronized manner and delivered to the site for erection. As a result, construction time is significantly shortened. In addition, steel has a lighter weight compared to other materials such as concrete, thereby reducing structural load pressure in all aspects.

Roofing Sheets

In addition to the steel frame, roofing sheets are used for enclosure and roofing in most industrial projects such as factories, warehouses, parking facilities, etc. Roofing sheets are increasingly popular due to their lightweight characteristics and diverse color options.

There are many types of roofing sheets, and selection depends on the specific project. Currently, there are three common types: insulated roofing sheets, standard roofing sheets, and translucent sheets. However, roofing sheets do not provide sound insulation, so noise reduction is limited.

Cladding Panels

You can build brick walls, cast concrete, or even use steel sheets as wall cladding.

In addition, cement fiber boards can be selected as cladding panels for pre-engineered buildings, replacing traditional fired bricks or concrete. Cement boards are lighter than traditional materials, helping reduce structural load pressure in all aspects of the building.

Construction Stages

Design

Architectural design drawings: Present design solutions, analyze and evaluate options, and provide consultancy to select the most cost-effective solution that meets the investor’s needs. Then, finalize architectural, structural, and material designs and express design intent through perspective views, elevations, floor plans, and sections.

Production and construction drawings: Once architectural and structural drawings are approved, structural drawings will detail each component and clearly assign identification codes. Errors in drawings may lead to extremely serious issues affecting construction quality.

Fabrication

The fabrication process includes the following steps:

Steel frame cutting and shaping: Steel plates are fed into cutting machines and cut according to structural drawings into individual steel blanks for each fabricated component. The edges are beveled, then butt-welded for oversized components.

Base plate fabrication: Holes are punched in base plates (continuous hole punching), then bolts are used to connect steel structures.

Assembly: Components are straightened and edge-rounded, then assembled into structural members using temporary welds.

Welding: Automatic submerged arc welding is used to connect components into a unified structural member.

Straightening: Welding may cause distortion, so warped surfaces are straightened using hydraulic equipment to ensure accuracy during erection.

Base plate assembly: Both ends of the structural member are cut before installing base plates, then base plates are tack-welded onto the truss body.

Surface cleaning: Components are cleaned and surface roughness is created. Cleaning ensures good paint adhesion and resistance to weathering.

Erection

Requirements

You must be able to read and understand layout drawings, detailed component positioning, and erection sequences in erection drawings to ensure construction quality and safety. This stage is carried out with strong support from cranes to lift components to height.

Main stages in the erection process:

  • Survey, inspection, and planning for preparation work, equipment, delivery, and storage of materials at the site
  • Planning supervision, inspection, and coordination
  • Installation of rigid frame columns
  • Installation of rafters and beams
  • Installation of frames, purlins, purlin bracing, and gable frames
  • Pulling roofing sheets and roof installation
  • Installation of wall purlins, wall cladding, gutters, and downpipe
  • Installation of doors and other accessories
  • Quality inspection and evaluation

Note: All these stages require careful consultation from architects, structural engineers, and material solution suppliers to achieve the best results in terms of cost, time, aesthetics, and functional performance of the building.

HOW MUCH DOES A RESIDENTIAL PRE-ENGINEERED STEEL BUILDING COST?

The Healdsburg SHED pre-engineered steel building project serves community activities and includes a restaurant and commercial area.

Construction companies calculate costs based on the building area on your land. Therefore, if you do not provide clear and detailed information, it will be difficult to obtain accurate quotations from contractors.

Below are the cost items you need to consider.

  • Construction material costs: Including costs of raw steel materials, construction materials, auxiliary materials, and finishing materials.
  • Labor costs: Including skilled workers, assistant workers, and cleaning staff.
  • Construction machinery costs: Including steel structure erection equipment, excavators, lifting machines, and other machinery.

In general, pre-engineered steel buildings are 10% to 30% cheaper than traditional reinforced concrete construction, depending on project volume and scale.

  • Residential Pre-Engineered Steel Building Unit Prices (USD/m²)
  • Shallow foundation option: 19 – 23
  • Pile foundation option: 23 – 27
  • Structural frame: 54 – 62
  • Finishing works: 115 – 135

The Above Unit Prices Apply to Buildings with the Following Basic Structures (Steel Portion Only)

  • Shallow foundation option: Reinforced concrete isolated footings with a depth of 1.5 m
  • Pile foundation option: Commonly using 200×200 piles with a length of 15 m and reinforced concrete tie beams
  • Structural frame: Built-up steel structures SS400 or Q235, finished with one anti-rust primer coat and two color paint coats
  • Finishing works: Galvanized steel deck flooring with one steel deck layer and M250 grade concrete topping

However, Construction Costs Also Depend on Other Factors Such As:

  • Construction location
  • Project scale
  • Building function
  • Architectural form
  • Construction timing
  • Steel Structure Fabrication and Erection Unit Prices (USD/m²)
  • Steel truss fabrication: 0.15 USD/kg
  • Steel truss erection, ridge ventilator, door console installation: 0.08 USD/kg
  • Steel truss erection, ridge ventilator, door console installation: 1.46 USD/m²
  • Roof sheet installation: 0.54 USD/m²
  • Wall sheet installation: 0.62 USD/m²
  • Gutter and drainage pipe installation: 2.50 USD/m
  • Flashing installation: 0.54 USD/m

Materials Used for Finishing a Residential Pre-Engineered Steel Building

Foundation and masonry materials:

  • Main material cement
  • Main material sand and aggregates
  • Main material steel
  • Main material electrical wires
  • Main material water pipes
  • Main material M250 grade concrete

Steel columns, rafters, wall and roof sheet materials:

  • Main material roofing sheets
  • Main material black or galvanized C-purlins with thickness 1.4 – 2.0 mm
  • Main material hollow steel sections 50×100, 60×120
  • Main material steel trusses, columns, base plates, steel plates
  • Main material Sika grout for concrete bonding, bolts, tension cables

Finishing materials for residential pre-engineered steel buildings:

  • Main material gray Sika flooring, epoxy
  • Main material floor tiles 600×600, 800×800
  • Main material water-based paint
  • Main material rolling shutter doors
  • Main material windows and emergency exit doors

MRM STEEL – SUPPLIER OF MATERIALS FOR PRE-ENGINEERED STEEL BUILDING PROJECTS

Pre-engineered steel buildings are currently considered a modern construction solution, effectively meeting requirements in terms of investment costs, construction schedules, and design flexibility. This model is suitable for a wide range of projects, from industrial factories, warehouses, and logistics centers to commercial and residential buildings.However, to ensure high quality, long-term durability, and optimal performance of pre-engineered steel buildings, selecting reputable steel materials and roofing sheets plays a crucial role.

MRM Steel is a leading brand in the United States, specializing in supplying high-quality metal roofing and steel materials that fully meet stringent technical standards for modern pre-engineered steel building projects. The product portfolio provided by MRM Steel includes high-quality metal roofing sheets for pre-engineered steel buildings; in addition, roof and wall panels for factories, warehouses, and industrial facilities, as well as structural steel materials for pre-engineered steel building frameworks. Finally, MRM Steel offers comprehensive steel and metal roofing material solutions for commercial and residential projects.

Using materials from MRM Steel not only enhances the durability and safety of the structure but also helps optimize construction costs, improve operational efficiency, and increase long-term value. Contact MRM Steel today for detailed consultation and fast quotations via hotline: (877) 289-6429.
